Plans Carried Forward by Default
Areas are included because they were audited previously, not because their risk warrants it. There is no documented basis for including one area and excluding another.
A risk-based audit plan, approved by the CAE and carried through to the final report
An internal audit plan must demonstrate why each area has been included. In RiskMan GRC, your team defines auditable areas by category, process and sub-process, scores them against risk factors weighted by your organisation, and can optionally take account of the assurance already provided by other functions. The score determines each area's risk band and audit frequency. The Audit Manager submits the plan to the Chief Audit Executive (CAE). Once approved, the plan is locked and an audit project is created, with every area set up as a process. The team then issues document requests, performs testing, completes reviews and reports, process by process.
The expertise is rarely the problem. The difficulty is that the work is spread across workbooks, email threads and shared folders, and keeping them aligned becomes a task in itself.
Areas are included because they were audited previously, not because their risk warrants it. There is no documented basis for including one area and excluding another.
Weights and scores change between file versions, and the rationale behind the ranking is lost when the person who built the workbook leaves.
The plan is agreed in a meeting or by email, leaving no reliable record of what was approved and when.
Once fieldwork begins, requests, workpapers and responses are scattered across folders, and the link to the approved plan is lost.
Build the audit universe, score each area against weighted risk factors, and convert the results into an annual plan for CAE approval. The approved plan automatically becomes an audit project, and each process within it moves through requests, testing, management response and the final report.
Define auditable areas for each entity by category, process and sub-process. Start from the built-in library of ten categories, import from Excel, or populate the universe by uploading an RCM.
Weight the risk factors to total 100% and score each area against them. Audit history, including the last audit date, previous rating and management concern, adjusts the result and assigns each area a band and a rank.
Rate the coverage already provided by the first line, the second line and external providers. The ranking then shows where internal audit attention is still required.
Each band determines audit frequency, from every six months for Critical to every three years for Low. Areas due this year are added to the plan with an assigned quarter and hours.
The Audit Manager submits the plan, and the CAE either approves it or returns it with a reason. Approval locks the scores, ranking and schedule.
After approval, each area is assigned a lead auditor and a start date, and the auditor is notified. Reminders are sent for unassigned areas and when a start date arrives.
For each process, the auditor prepares the audit programme, either by uploading it or by generating test steps, and assigns a client contact to each line. The Audit Manager approves the programme before the information request is sent to the auditee.
Auditors test design and operating effectiveness, document the workpaper and record the root cause. The Audit Manager reviews each line and the CAE approves the testing. Either reviewer can return it for rework.
For each observation, the control owner records the management response, target date and responsible person. The process owner, auditor, Audit Manager and CAE approve it in sequence, after which the final report for the area is issued.
Request early documents from the business before the audit programme is finalised, track outstanding items for each contact, and store every audit file in the project's dedicated drive.
View the number of plans and areas, the universe by risk band, scheduled versus due areas, audits per quarter, the status of each audit and findings by severity.
Screenshots from the live product.

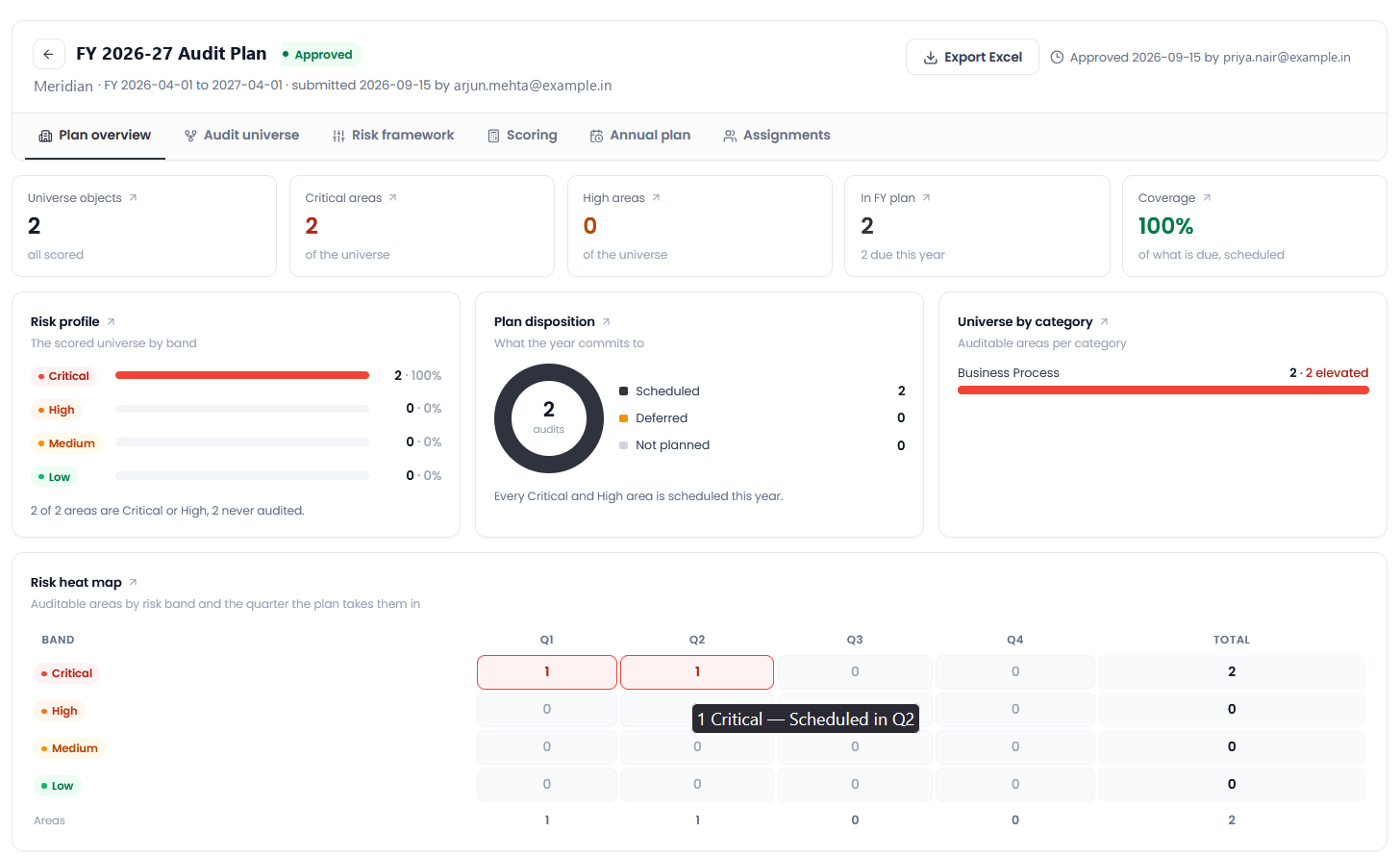

The plan overview follows the sequence in which the plan was built: universe, risk factors, scoring, annual plan and assignments. Below these, it shows the scored areas by band, the coverage for the year and the quarter assigned to each area, along with the plan's submitter and approver.
Four phases, from building the plan to following up on findings. Each step shows who performs it and the record it produces.
The Audit Manager builds the plan in a guided wizard. Progress is saved at each step, and the plan cannot be submitted until every step is complete.
Select the group, the entities and sub-entities in scope, the financial year and the scoring scale. At this stage, you also decide whether the plan will use assurance mapping.
Define every auditable area for each entity at three levels: category, process and sub-process. Start from the built-in library of ten categories, import an Excel file, or populate the universe by uploading an RCM.
Select the relevant risk factors from the library, grouped into four pillars, each with a defined 1, 3 or 5 scoring guide. Assign a weight to each factor. The weights for an entity must total 100%.
Score every area against the selected factors. Audit history adjusts the score, based on when the area was last audited, its previous rating and any concern raised by management. Each area then receives a composite score, a band and a rank.
Weight the first line, second line, external providers and third line, and score the coverage each already provides for an area on a scale of 0 to 3. The ranking then reflects the assurance internal audit still needs to provide.
The band determines audit frequency: every 6 months for Critical, every year for High, every 2 years for Medium and every 3 years for Low. Each area receives its next due date, and the areas due this year are identified.
Areas due this year are added to the plan. Each is assigned a quarter (Q1 to Q4, or allocated automatically) and audit hours, from which days and cost are calculated. Align the plan with your team's capacity, defer an area with a reason, or bring one forward.
The plan is approved once, by the CAE, and that approval initiates the audit work.
The Audit Manager submits the plan, which is validated first. The universe must not be empty, the weights must total 100%, all areas must be scored and the plan must contain at least one line.
The CAE approves the plan or returns it with a mandatory reason. On approval, the scores, weights, bands, ranking, quarters and hours are locked, and the decision is logged with the approver and date.
The approved plan automatically becomes one audit project. Every area in the plan becomes a process within it, and the team is populated from the plan: the CAE, the Audit Manager and the assigned auditors.
Each area is assigned a lead auditor and a planned start date, and the auditor is notified by email. Reminders are sent for unassigned areas, and to the auditor on the morning the start date arrives.
Each process in the project moves through its own stages, so one area can be in testing while another is still awaiting documents.
The Staff Auditor builds the audit programme for the process by uploading it from Excel, generating test procedures and the information request with AI, or entering them line by line. Each line is assigned a client contact. Early documents can be requested through a preliminary data request.
The Staff Auditor submits the programme to the Audit Manager, who approves it or returns it. On approval, the Information and Document Request (IDR) is released to the auditee.
The client contact uploads documents against each request from their own screens, and the audit team tracks received and pending items. All files are stored in the project's drive.
For each line, the auditor records the audit procedure, the design walkthrough and its conclusion, the population, sample size and method, the attributes tested, exceptions and the final conclusion. Annexures and evidence are attached to the workpaper.
The Audit Manager reviews the workpapers line by line, and the CAE then approves them. Either reviewer can return a line with comments. On CAE approval, a finding is raised for every failed line, classified by type and rated Low, Medium, High or Critical.
Findings are sent to management for a response, and the report is issued once that response is approved.
For each observation, the control owner records the management response, action plan, responsible person and target date, for both the immediate and the systemic remediation. The auditor's observation, risk, recommendation and root cause are displayed alongside.
The response is reviewed by the process owner, then the Staff Auditor, the Audit Manager and finally the CAE. Any of them can return it for revision.
On CAE approval of the response, the final audit report for the area is generated as a PDF from the approved tests and responses. An area with no gaps is reported as soon as its testing is approved.
An auditee satisfaction survey opens with the report. Failed items and their responses move to the Action Taken Report module, where each action is tracked to closure.
The records the module produces, and the regulations and frameworks they support.
These references describe the context the module is designed to support. They are not a statement of certification, and do not replace professional judgement on your reporting obligations.
Every role works on the same record, and each sees the part for which it is accountable.
If your question is not covered here, please contact us and our team will answer it for your specific requirements.
Your team weights a set of risk factors to total 100% and scores each area against them. Audit history, including when the area was last audited, its previous rating and any management concern, adjusts the result. The score places the area in a band (Critical, High, Medium or Low) and assigns it a rank.
No. It is selected during plan setup. If it is used, the coverage provided by the first line, the second line and external providers is scored and reflected in the ranking.
The scores, ranking and schedule are locked, and an audit project is created for the plan with each area as a process. The Audit Manager then assigns a lead auditor and a start date to each area.
Largely, yes. After planning, each process moves through an audit programme, information requests, testing, management response and a final report. Internal audit adds an Audit Manager approval before the request is issued and a process owner approval of the management response.
When the final report is released, the failed items and their management responses move to the Action Taken Report module, where they are tracked to closure.
Schedule a one-hour session with our team. We will demonstrateRBIA using your own processes and controls, so you can assess how a complete cycle would work for your organisation.
